Asbestos in asphalt: A complete guide to risks, regulations and diagnosis
|
|
Time to read 8 min
|
|
Time to read 8 min
Summary
Asbestos. The word alone is enough to evoke a major health hazard. While often associated with older buildings, its presence is also a worrying reality beneath our feet, in the layers of bituminous asphalt that make up our roads, parking lots, and public thoroughfares. For construction professionals, local authorities, and project owners, managing asbestos in asphalt has become a crucial issue, governed by strict regulations. Ignoring this risk jeopardizes workers' health and exposes one to significant liability.
This comprehensive guide, written for you by the experts at Pouryère, aims to demystify the issue of asbestos in asphalt. We will cover its history, health risks, the complex legal framework, diagnostic methods, and waste management. The goal: to give you the tools to approach your roadworks projects safely and in compliance with regulations.
For decades, the road construction industry has sought to improve the durability and resistance of its pavements. It is in this context that asbestos, for its binding and reinforcing properties, has been incorporated into certain bituminous mix formulations.
The incorporation of asbestos fibers into asphalt mixes was primarily aimed at improving their mechanical performance. According to a document from Cerema, this practice took place in France between 1974 and 1995. The asbestos, generally chrysotile at a level of approximately 1% of the total mass, acted as a stabilizer, increasing resistance to rutting and cracking.
However, the total ban on asbestos in France, enacted by decree n°96-1133 of December 24, 1996 , put an end to this practice from 1997. All roads built or renovated before this date are therefore potentially asbestos-containing.
The problem becomes more complex with the distinction between two types of asbestos presence:
The danger of asbestos in asphalt is not apparent when the road surface is intact. The risk arises during work that generates dust: milling, core drilling, sawing, demolition, etc. These operations release asbestos fibers into the air that are invisible to the naked eye.
Inhaling these fibers can cause serious respiratory illnesses, which often develop decades after exposure. The circular of May 15, 2013, reminds us that inhaled fibers can settle deep in the lungs and cause:
Exposure to asbestos, combined with that to Polycyclic Aromatic Hydrocarbons (PAHs) also present in old asphalt, is a major cause of occupational cancers, with more than 3000 new cases of lung or bladder cancer per year in France.
The first to be exposed are roadworks workers. However, in the absence of adequate protective measures (containment, watering), the dust cloud can spread and also affect residents and the public near the construction site.
This is the cornerstone of prevention. It is strictly forbidden to begin work on a road without first checking for the presence of asbestos. This obligation is established by the Labor Code and further defined by several key texts:
Since 2016, carrying out an asbestos diagnosis in asphalt is therefore mandatory before any roadworks project.
The asbestos survey, or Asbestos Identification Before Work (RAT), is much more than a simple formality. It is a structured process that determines the entire rest of the construction project.
The surveyor, who must possess specific validated skills, follows a rigorous process:
1. Document analysis: Study of road plans and history.
2. On-site inspection: Reconnaissance visit to define the sampling program.
3. Definition of zones: Identification of "Zones Presenting a Similarity of Work" (ZPSO), which for asphalt correspond to layers of homogeneous materials.

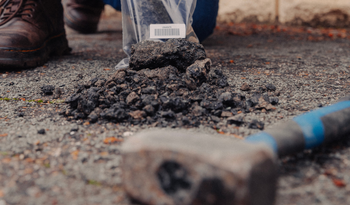

4. Sampling: Core sampling will be carried out in each identified layer. The number of boreholes depends on the surface area of the zone.
Analyzing asphalt samples is complex because the bitumen "masks" the fibers. Laboratories use specific techniques to separate the binder from the aggregates before analysis.
Specialized laboratories such as Eurofins or ITGA offer these complex analyses, which are covered by COFRAC accreditation.
Did you know? Asbestos testing is often combined with the search for Polycyclic Aromatic Hydrocarbons (PAHs). These compounds, derived from tars previously used, are also classified as carcinogenic, and their presence determines the recycling or waste disposal channels.
To simplify this process, Pouryère has developed VRDKIT. It allows you to safely collect the sample yourself and then send it to our COFRAC-accredited partner laboratory. Within 7 days, you will receive a comprehensive report analyzing both the presence of asbestos (MOLP/META) and the PAH content. It's the ideal solution for obtaining a reliable and rapid diagnosis before planning your work.
A positive diagnosis for asbestos does not mean the project will be stopped, but it does require strict precautionary measures and rigorous waste management.
If asbestos is detected, the contractor must comply with the provisions of the Labor Code relating to work on asbestos-containing materials (known as "subsection 4"). This includes:
The law is unequivocal: the producer of the waste is responsible for its management until its final disposal. The recycling or reuse of asphalt containing asbestos is strictly prohibited.
Waste from asbestos-containing asphalt must follow a specific disposal channel:
1. Packaging: Waste must be placed in double sealed packaging (e.g., sealed "big bags") with visible "asbestos" labeling.
2. Traceability: Each batch of waste must be accompanied by an Asbestos Waste Tracking Form (BSDA), now dematerialized via the Trackdéchets platform.
3. Disposal: Asbestos-containing asphalt is considered construction waste. It must be disposed of in Non-Hazardous Waste Storage Facilities (ISDND) authorized to receive asbestos, in specific cells. Under no circumstances may it be disposed of in Inert Waste Storage Facilities (ISDI).
Even before the start of construction, the company must obtain a Prior Acceptance Certificate (PAC) from the storage facility that will receive the waste.
No, not systematically. Asbestos was only used in certain formulations to improve their performance. However, in the absence of evidence to the contrary (construction records, etc.), any road dating from before 1997 must be considered as potentially containing asbestos, which makes pre-work asbestos testing mandatory.
Yes. The regulations apply to any work likely to generate dust, including cutting, pothole filling, milling, or demolition of road surfaces. As soon as there is any alteration to the asphalt structure, the risk exists and a diagnostic assessment is required.
The responsibility lies with the client or the project owner. This could be a local authority (town hall, department), a motorway company, a condominium association for a private car park, or any company commissioning work on a road under its responsibility.
No, the analysis must be performed by a COFRAC-accredited laboratory. However, solutions like Pouryère's VRDKIT allow you to collect the sample yourself in a guided and secure manner before sending it to the laboratory. This simplifies logistics while guaranteeing the conformity and reliability of the analysis.
The Technical Asbestos Dossier (DTA) concerns buildings and aims to inform occupants and maintenance companies of the presence of asbestos. The Asbestos Survey Before Work (RAT) is specific to a given construction site. It is much more destructive and comprehensive than the survey for a DTA, as it aims to identify all asbestos-containing materials that will be affected by the planned work.
The penalties are severe. The project owner risks criminal prosecution for endangering the lives of others, immediate work stoppage by the labor inspectorate, and administrative fines. In the event of a subsequent occupational illness, their liability for inexcusable negligence may be invoked.
Managing asbestos in asphalt is a complex but essential requirement to ensure everyone's safety. By staying informed and relying on reliable assessments, you can transform a regulatory obligation into an effective preventative measure. For any questions or to order your testing kit, please don't hesitate to contact the experts at Pouryère.
Pouryère supports you throughout the entire soil analysis process. Our sampling kits come with a comprehensive guide to walk you through the process. Once you've completed the analysis, simply send us your samples for full analysis and interpretation, which takes approximately ten days.
